Kitchen fitting, with the building work included

We fit kitchens the way we'd fit our own: carcasses levelled and fixed into something solid, worktops scribed to the wall, every trade booked in the right order. Howdens, Wren, Benchmarx or someone else's, they get the same care, and if the room needs walls, floors or boxing in first, we do that too.

Finished open plan kitchen in a vaulted extension, matt black handleless units and a long island
Matt black handleless kitchen with island, fitted in a vaulted extension, May 2024.
What we fit
Kitchens you've bought, plus the walls, floors and boxing in around them
Brands fitted
Howdens, Wren, Benchmarx and other supplier kitchens
Gas and electrics
Gas Safe engineer for gas, a registered electrician for new circuits
Your quote
Written and itemised after we've seen the room
Matt black handleless tall units and wall cabinets behind an island with a solid oak waterfall breakfast bar

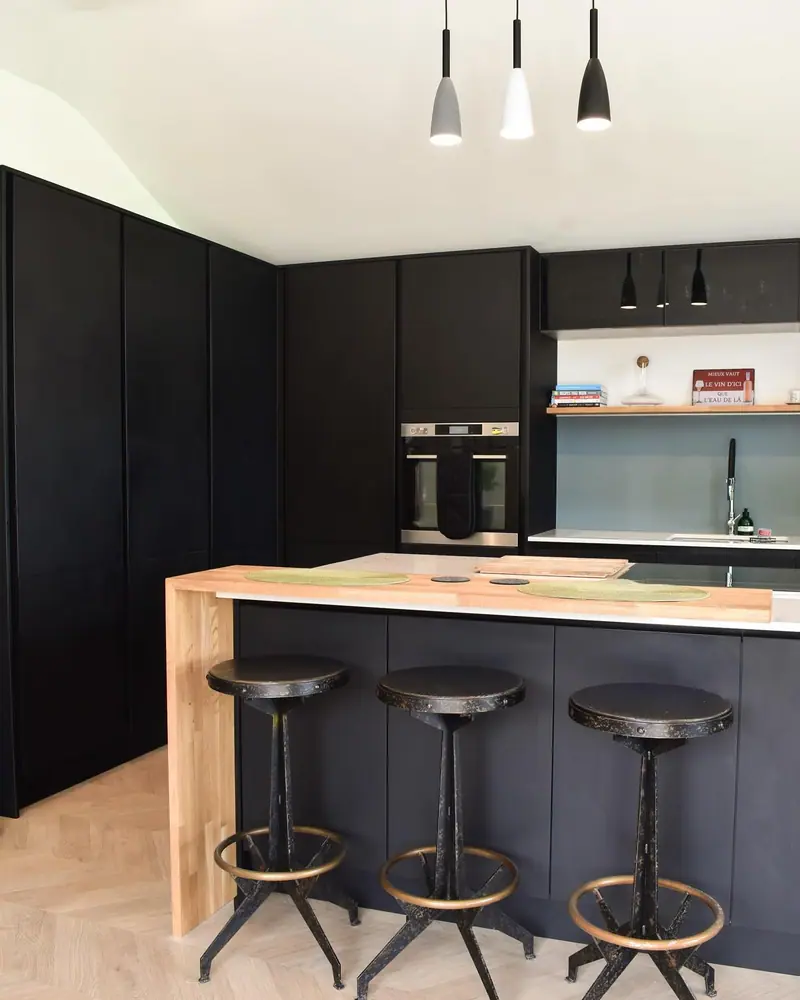

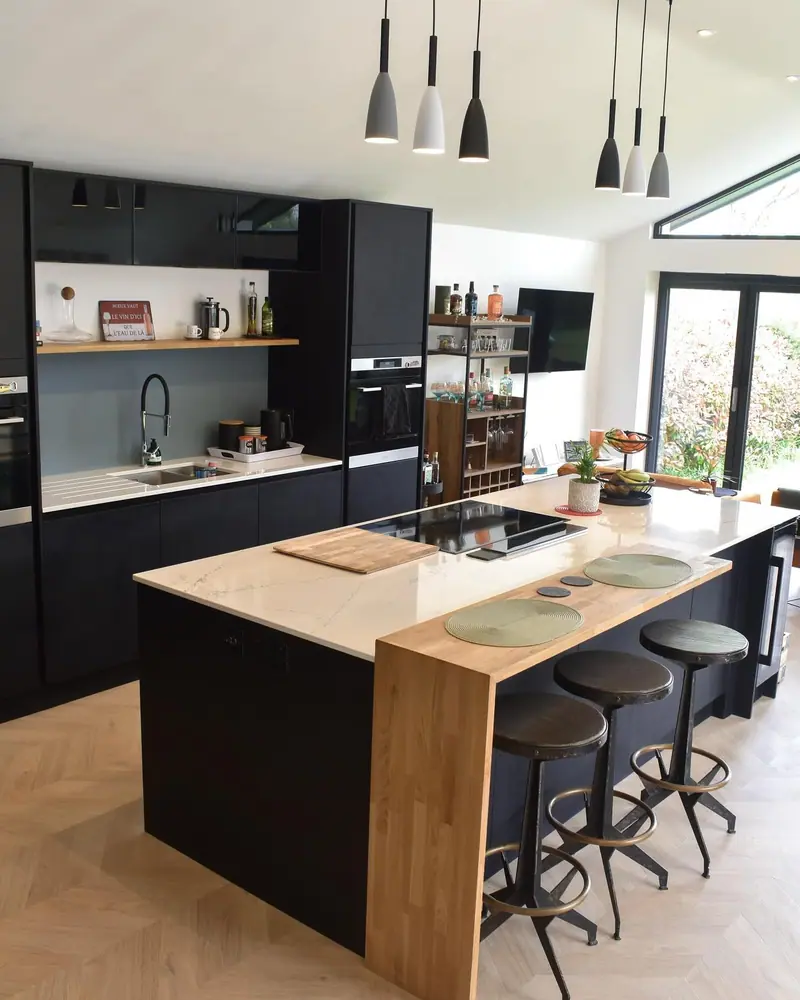

Open plan kitchen in a vaulted extension, matt black handleless units and a long island with stools
Black tall units with two built-in ovens, glass fronted wall cabinets and a floating oak shelf

A black handleless kitchen with an oak waterfall bar

This one went into a vaulted single-storey extension in spring 2024: matt black handleless Howdens units, a full-height wall of tall larder and oven housings, and a long island with a flush induction hob. The island finishes in a solid oak waterfall breakfast bar, the oak running across the top and down to the floor. Handleless kitchens show everything. There's no handle to catch your eye, so the gaps between the doors and the line of the rail have to be dead even along the whole run, and that only happens if the carcasses underneath are level and fixed tight. Get one unit a couple of millimetres out and you see it every time you walk in. The oak end is the same story. The top and the leg have to meet square and the leg has to stand plumb, or the whole bar looks like it's leaning. It's the photo we'd show anyone asking what we mean by a kitchen fitted right.

Where
Location kept private
On site
April 2024
Property
House with a vaulted single-storey extension
Our role
Kitchen fitting

Fitting a Howdens, Wren or other supplier kitchen

Howdens, Wren, Benchmarx: we've fitted all three, and kitchens from other suppliers too. They all get fitted the same way, because the name on the boxes matters a lot less than how the units go in.

Howdens is the one people ask about most. It only sells through trade accounts, so a Howdens kitchen is bought through a builder or a fitter, and although depot staff can point you to local tradespeople, there's no Howdens fitting team. Howdens doesn't run an approval scheme for fitters either, so treat "Howdens approved" as a phrase, not a qualification. We're independent fitters, and we fit Howdens kitchens the same as any other.

If you've bought the kitchen yourself, the contract for the units is between you and the supplier. That's why the delivery check matters. The kitchen should be in the house, every box opened and checked against the plan, before the old one comes out. Missing hinge packs, a wrong end panel and a scuffed door are all common, and it's much better to find them while you've still got a working sink. Waiting on the supplier for the last few bits comes up in more than one of our own posts.

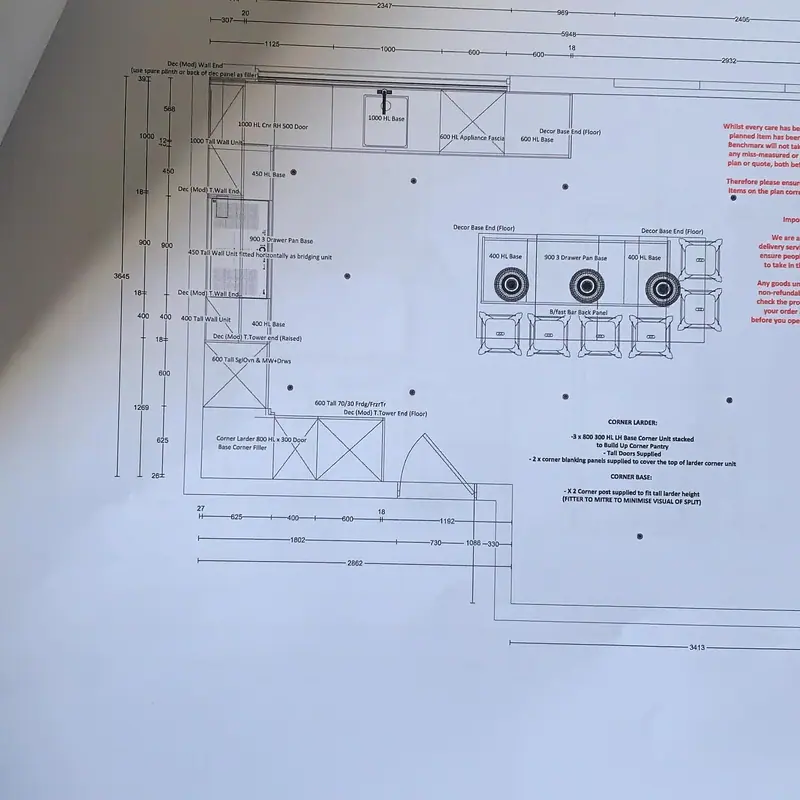

Send us the supplier's plan before you order if you can. A fitter looking at it spots what a showroom plan can miss: a tall unit hard against a window reveal, no route out for the cooker hood duct, a dishwasher with nowhere sensible to drain.

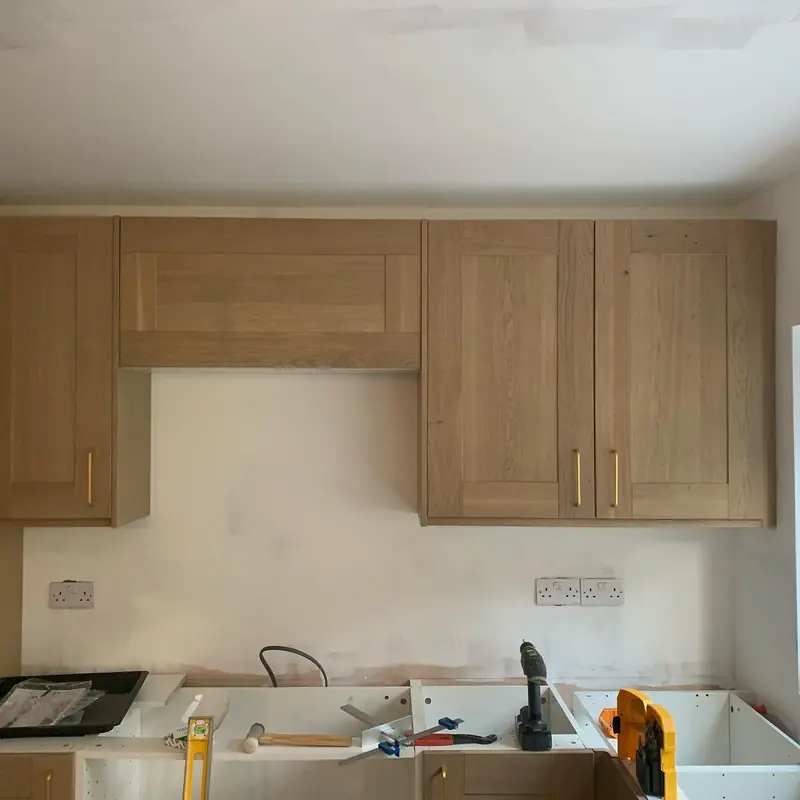

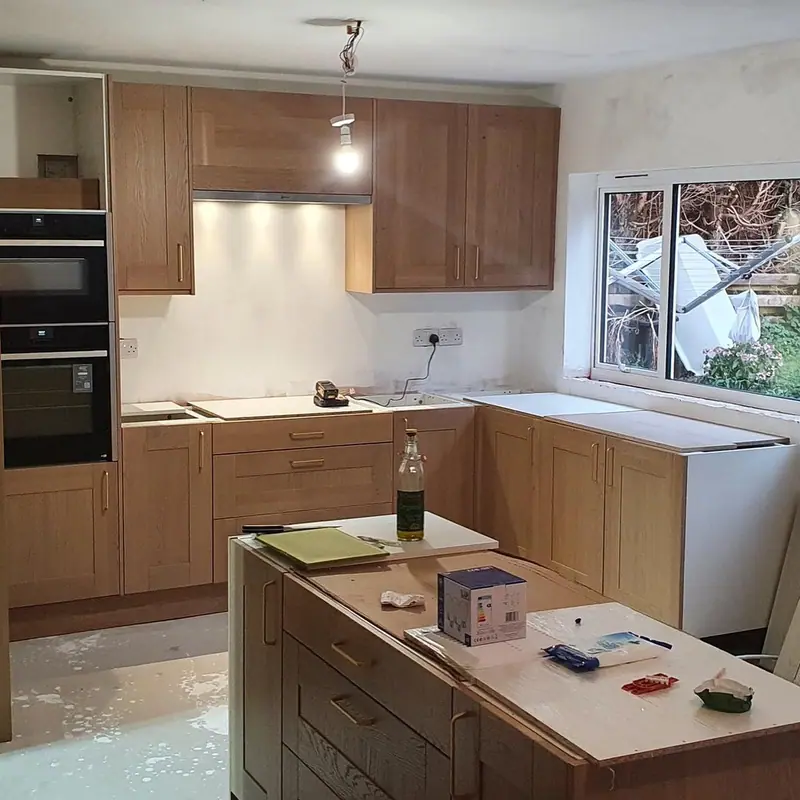

Oak shaker wall units with brass bar handles hung over base carcasses, with tools resting on top

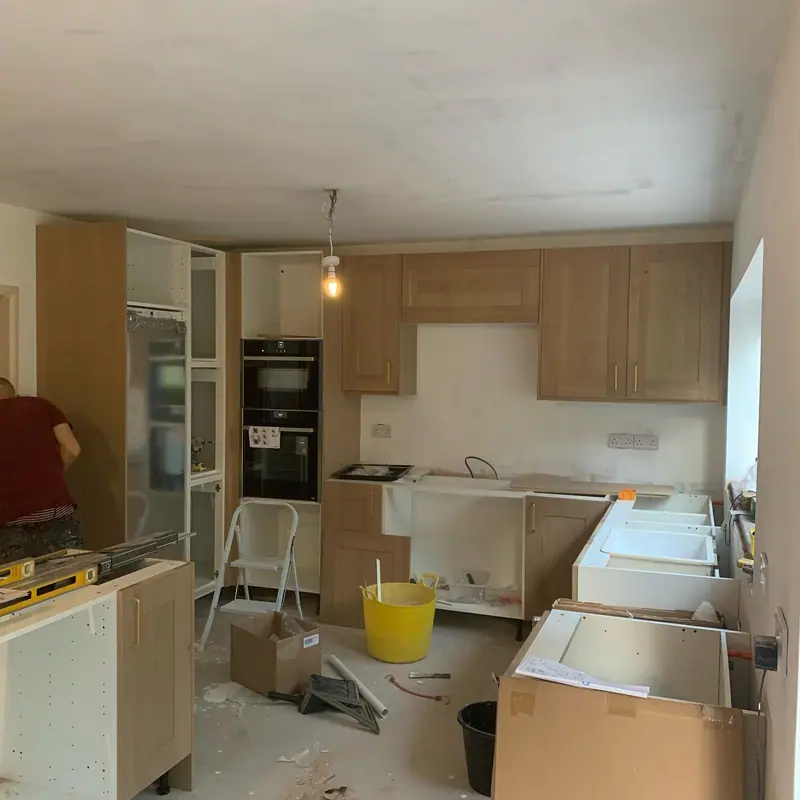

Our work, September 2021. Wall units hung and base units set, ready for worktops.

When the kitchen needs building work too

A kitchen fitter fits units. Because we're carpenters who build, the rest of the room is part of the same job: a stud wall moved to make space for a larder, pipes boxed in, a new floor laid before or after the units, walls boarded and made good once the old kitchen is out. On one weekend kitchen in April 2023 that meant new floors, the coving off and the walls filled flat before the plumber and electrician came in.

Taking a wall out is a different kind of job. If it's load-bearing, it needs a structural engineer's design and Building Regulations approval. Most structural alterations need that approval even when they don't need planning permission. If the new steel bears on a wall you share with next door, a party wall notice has to go in at least two months before work starts. And in a house with a floor more than 4.5 metres above the ground, usually a three-storey house, opening the kitchen into the hall can break the protected route down the stairs, which the design has to deal with.

So a knock-through is a structural job first and a kitchen second. Our knock-throughs and steel beams page explains how that part runs. The kitchen goes in once the opening is signed off, and the rules section below covers the rest.

New softwood stud walls framed under a red steel beam in a house being opened up
Our work, January 2022. Stud walls framed under a new steel in a knock-through.

What a kitchen fit covers

A fitted kitchen is a lot more than units on a wall. This is what's in the job when we do it, and what each part needs to get right.

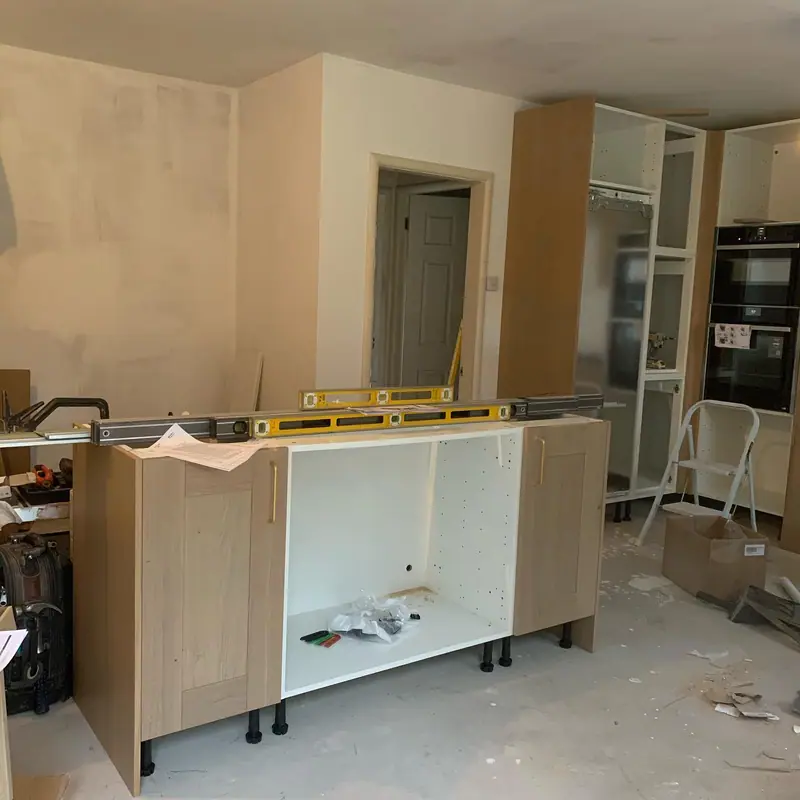

  1. Island base units with oak shaker doors being checked with long spirit levels across the tops

    Units and carcasses

    Base units set to a laser line so every top sits flat. Wall units fixed back to studs, noggins or masonry, never plasterboard plugs alone.

  2. Grey gloss L shaped kitchen mid install with a white stone effect worktop and sink cut out

    Worktops

    Laminate and timber cut, jointed and sealed on site. Stone is templated once the units are fixed and fitted by the fabricator's team.

  3. Navy peninsula with a solid oak bar end and open oak shelving, carcass tops still bare

    Islands and bar ends

    Islands fixed down, with power and water planned before the floor goes in. Oak bar ends and waterfall legs scribed and set plumb.

  4. Light grey shaker kitchen run on legs with two built in ovens, waiting for its worktop

    Appliances and tall housings

    Ovens, fridges and dishwashers housed to the maker's gaps and ventilation, with integrated doors lined up with the rest of the run.

  5. Floor to ceiling grey shaker tall units with a curved end panel built into a recess

    Plinths, panels and fillers

    End panels and fillers scribed to the wall, plinths cut clean and fitted after the floor, cornice and pelmets mitred at the corners.

  6. Engineered oak floor laid across an open plan room, unfinished kitchen carcasses standing on the left

    Floors, walls and boxing in

    The building side: stud walls, boxing in pipes, boarding and making good after the strip-out, and the floor laid before or after the units.

  7. Base units with a hob cut out and loose cables waiting for the electrician, beside the dishwasher

    The other trades

    Gas to a Gas Safe registered engineer, new circuits to a registered electrician, plumbing in the right place in the order. Who comes when matters.

Rigid or flat-pack: what difference does it make?

Rigid units arrive already built. Howdens and DIY Kitchens supply theirs that way, although DIY Kitchens sends walk-in corner larders flat-packed and offers a dry-assembled option, up to three units an order, for tight access. Wren's Vogue range and IKEA's METOD system come flat-packed. Wren's Infinity and Infinity Plus ranges come ready-built.

Flat-pack isn't worse once it's up. It's slower to fit, because every carcass has to be built on site before it goes anywhere near the wall, and that time shows up in the quote. If you're torn between two similar kitchens, our view is that ready-built carcasses usually go in quicker and squarer.

The guarantees differ as well. Wren gives 15 years on Vogue, 20 on Infinity and 25 on Infinity Plus, and DIY Kitchens gives 25 years on its units. Those are the makers' guarantees on the units themselves, so keep the paperwork with the rest of your handover pack.

Laminate, timber, quartz or sintered stone worktops?

Our view after fitting all of them. Whichever you pick, decide before the survey, because stone changes the order of the whole job.

WorktopHow it goes inWhat to watch forLiving with it
LaminateCut, jointed with a router and worktop jig, and fitted by us on the dayWater in an unsealed joint or cut-out swells the chipboard core, so every cut edge gets sealedEasy to live with and easy to replace. Hot pans go on a trivet
Compact laminateSolid laminate around 12mm thick, cut with specialist toolingHeavy, and a wrong cut can't be hiddenWaterproof right through, so it can take an undermount sink
Solid timber: oak, iroko or walnutCut and jointed on site, oiled before it goes on and again afterStanding water round the sink. It needs re-oiling now and thenThe only top you can sand back and bring up like new
QuartzTemplated once the units are fixed, made off site, then fitted by the stone teamNot fully heat-proof, and the dust from cutting it carries silicaEven colour and good with stains. Use a trivet, whatever the showroom said
Sintered stone and porcelainTemplated and made off site, the same way as quartzEdges can chip on a sharp knockShrugs off heat, sunlight and scratches

Engineered quartz can contain up to 95% crystalline silica. On 11 May 2026 the HSE said dry cutting it is unacceptable and began more than 1,000 inspections of worktop fabricators. Stone should be cut wet, with extraction, at the fabricator's workshop wherever possible, and lower-silica products are now available if you'd rather have one.

Do I need building regs for a new kitchen?

For a straight swap on the same layout, usually not. It's the changes that bring the rules in: a new electrical circuit, a new waste into the soil stack, a gas hob moved, new extraction or a wall coming out. We tell you which apply at the survey, and you get the certificates at the end.

RuleWhat it means for youSource
New circuits and consumer units (Part P)A new circuit, say for an island hob or a second oven, or a new consumer unit is notifiable. Extra sockets on an existing kitchen circuit usually aren't. The electrician certifies the work, not us.Approved Document P
Gas hobs and cookersOnly a Gas Safe registered engineer may connect or move a gas hob or cooker. Ask for the paperwork when they've finished and keep it with the house documents.Gas Safety (Installation and Use) Regulations 1998, reg 3
Extraction (Part F)A kitchen needs extraction of 30 litres a second through a cooker hood that vents outside, or 60 litres a second without one. A recirculating hood on its own doesn't count. In a refit, an existing outside-venting hood or fan should be kept or replaced, not taken out.Approved Document F
Sinks, wastes and boiling taps (Part G)Every kitchen needs a sink with hot and cold water. Tying a new waste into the soil stack or an underground drain is building work. A boiling water tap holding 15 litres or less isn't notifiable on its own.Approved Document G
Taking out a wall (Parts A and B)A load-bearing wall needs an engineer's design and approval. In a house with a floor more than 4.5 metres up, opening the kitchen into the hall can affect the escape route.Approved Document B, Volume 1
Party wallsWork on a shared wall, like cutting in steels or removing a chimney breast, needs a party wall notice at least two months before it starts.Party Wall etc. Act 1996, section 3
Listed houses and leasehold flatsWork that affects the character of a listed building, inside or out, needs listed building consent first. In a leasehold flat you'll usually need the freeholder's consent before re-planning the kitchen.Planning (Listed Buildings and Conservation Areas) Act 1990, section 7

Who signs it off

  • Lewis Brothers: which rules apply to your kitchen, at the survey
  • A registered electrician: new circuits and the certificate
  • A Gas Safe registered engineer: anything on the gas supply
  • A structural engineer and Building Control: any load-bearing wall
  • You: the party wall notice, if a steel bears on a shared wall

Checked November 2026 against Approved Documents B, F, G and P, the Gas Safety Regulations 1998 and the Party Wall etc. Act 1996

How a kitchen fit runs, start to finish

On a Howdens kitchen in March 2022 the order went: electricians and plumbers in, floor down, the last carpentry bits, then the quartz worktop. That order is most of the job. Get it wrong and someone ends up refitting a plinth or cutting into a finished floor.

  1. Survey

    Us

    We look at the room: the walls, the floor, where the services run now and where they need to go. If you've got the supplier's plan, we go through that with you too.

  2. Written quote

    Us

    An itemised quote that sets out what we do, what the other trades do, which rules apply and how many days we expect to be on site.

  3. Order and delivery

    You · Supplier lead times vary by brand and range

    You place the order, or confirm it. The kitchen should arrive and be checked against the plan before the old one comes out, so nothing is missing halfway through.

  4. Strip-out

    Us

    The old kitchen comes out and we see what's behind it. Walls and floor are made good, and any stud walls and boxing in go up while the room is empty.

  5. First fix

    The trades we book

    The electrician and plumber run new circuits, pipes and wastes while the walls are open, and gas goes to a Gas Safe engineer. Fresh boarding or skim dries before units go up.

  6. Units and worktops

    Us · Stone tops: a wait while the fabricator makes them

    Carcasses set to a laser line and fixed back to something solid, then doors and drawers hung. Laminate and timber tops go on now, and stone gets templated.

  7. Second fix and handover

    Us

    Sink, hob and appliances connected by the right trade, plinths and fillers fitted after the floor, doors adjusted and snags closed. You get the certificates and the makers' guarantees.

How much does kitchen fitting cost?

We don't publish prices, because two kitchens with the same number of units can take very different amounts of time to fit. Moving the sink or hob, an island with services, stone tops, flat-pack units and walls that are out of true all add days. So we price your room, in writing, after we've seen it.

  1. Rigid or flat-pack units

    Flat-pack carcasses are built on site before they go anywhere near the wall

    What helps: If two ranges are close, ready-built units usually save fitting time

  2. Number of units and tall housings

    More units mean more fixing, levelling and door adjusting, and tall larders and oven housings take longest

    What helps: Send the supplier's plan so we can count from it, not guess

  3. Moving the sink, hob or oven

    New waste runs, gas and cable routes, and sometimes the floor has to come up

    What helps: Settle the layout before the survey, not after the order

  4. An island with power or water

    The services have to cross the floor to reach it

    What helps: Plan the island before the new floor goes down

  5. Worktop material

    Stone is templated after the units go in and made off site, which adds a wait and a second visit

    What helps: Decide the material before the survey

  6. Walls and floor

    Out-of-plumb walls mean scribing every panel and filler, and an uneven floor means more levelling

    What helps: Nothing you can do, but we'll tell you what we find at the survey

  7. What's behind the old kitchen

    Nobody knows the state of the walls and pipes until the old units come off

    What helps: Keep a little back in the budget for making good

  8. Where the extraction goes

    Ducting out through a wall or a ceiling void takes longer than a hood on an outside wall

    What helps: Ask where the duct will run before you choose the hood

What our written quote lists

  • Strip-out and taking the old kitchen away
  • Building flat-pack units, if there are any
  • Worktop fitting, joints and cut-outs, or who fits the stone
  • Plinths, end panels, fillers and cornice
  • Extraction, and where the duct runs
  • Who does the gas, electrics and plumbing, and which certificates you get
  • Boarding, making good, tiling and flooring: in the quote or not
  • Days on site, and how any changes get priced

By the unit, by the day or for the job?

Fitters price kitchens three ways. By the unit sounds tidy, but it leaves out worktops, scribing, panels and services, which is where most of the time goes. By the day leaves the total open, so a slow week is your problem. We'd rather quote the job: one written price for the work, after we've seen the room.

The thing nobody can see is what's behind the old units. A good quote names that as a separate allowance instead of burying it in the total, so you know what it covers before work starts. Comparing quotes? Put them side by side against the list above. Our guide on how to compare builders' quotes goes through it line by line, and how we quote carpentry jobs explains our side.

Bought the units already? Send us the supplier's plan and a few photos of the room, and we'll tell you what the fit involves.

Get a quote

What a well-fitted kitchen looks like up close

Most of what you pay a fitter for disappears once the doors are on. These are the parts that decide whether the kitchen still looks right years from now.

  1. The shortcut

    Wall units hung on plasterboard fixings

    What we do instead

    Fixed back to studs, noggins or masonry. Where a stud wall has nothing behind the board, noggins go in while the wall is open.

  2. The shortcut

    Base units set level near enough, by eye

    What we do instead

    Every leg set to a laser line, so worktop joints sit flush and the doors close in one clean line.

  3. The shortcut

    A worktop butted to a wonky wall with a fat bead of silicone

    What we do instead

    Scribed to the wall, so the gap is gone rather than filled.

  4. The shortcut

    Worktop joints and cut-outs left raw

    What we do instead

    Joints glued and sealed, and every cut edge sealed before the sink or hob goes in.

  5. The shortcut

    Units fitted onto a wall that's still wet

    What we do instead

    New boarding or skim left to dry first, with the time allowed in the programme.

  6. The shortcut

    Plinths and scribe fillets fitted before the floor

    What we do instead

    Fitted after the floor goes down, so a new floor never traps them or the dishwasher.

  7. The shortcut

    A recirculating hood and nothing else

    What we do instead

    Ducted outside wherever it can be, sized to the 30 litres a second rule.

Close low view of a chunky solid oak bar top over an oak wine rack at a navy peninsula
Our work, April 2022. Solid oak bar end and wine rack meeting the quartz top.
Full height black tall units with two built in ovens, glass wall cabinets and an oak shelf
Kitchen fitting, May 2024. Tall oven housings lined up with the rest of the run.

Two kitchen fitting tips from our carpenters

Short clips from our Instagram, filmed on real jobs. Both show the part of a fit you never see once the plinths are on.

Setting kitchen unit legs to a laser Setting one leg on each base unit to the laser line first, so the unit goes in level without reaching underneath every time. Filmed in a newly finished garden room and posted in October 2024.
Jointing square-edged laminate worktops Square-edged laminate tops cut with a track saw and joined with a router and worktop jig, then the finished L-shaped top over sage shaker units. Posted in September 2022.

Questions people ask us about kitchen fitting

Something else? Call or WhatsApp 07494 000065.

Do Howdens have their own kitchen fitters?

No. Howdens sells through trade accounts, and depot staff can point you to local tradespeople, but the fitter you choose works for you, not for Howdens. There's no approval scheme for fitters to belong to. We're independent and fit Howdens kitchens the same way as any other.

Will you fit a kitchen I bought myself?

Yes, as long as it's complete and suits the room. Send us the supplier's plan first so we can spot anything that won't work, like a tall unit hard against a window or no route for the duct. Flat-pack units take longer, because each one is built before it goes in.

How long does it take to fit a kitchen?

It depends on the number of units, whether they're rigid or flat-pack, and whether the sink, hob or oven move. Your written quote states the days we expect to be on site. Stone worktops add a wait while they're made after templating, and a knock-through adds the structural work before any units go in.

Do you do the plumbing and electrics?

We do the carpentry and the building work and line up the other trades in the right order. Gas goes to a Gas Safe registered engineer, and new circuits go to a registered electrician who certifies the work. Be wary of any fitter who offers to do the gas without a Gas Safe card.

Do I need building regulations for a new kitchen?

For a like-for-like swap, usually not. A new electrical circuit, a new waste into the soil stack, a moved gas appliance or taking out a wall can all need sign-off. We'll tell you which apply at the survey, and the rules section on this page sets them out with sources.

Is a recirculating cooker hood allowed?

Not as your only extraction. The rules want air taken outside: 30 litres a second through a hood that vents out, or 60 litres a second from a fan somewhere else in the room. If your old kitchen had a hood ducted outside, the new one should keep that duct.

How much does a kitchen fitter cost?

We don't publish prices, because two kitchens with the same units can take very different amounts of time to fit. Moving the sink, adding an island, stone tops and the state of the walls make the biggest difference. We price your room in writing once we've seen it. The cost section lists what changes it.

Should the floor go down before or after the kitchen?

Either can work. A floor laid under the whole room first is tidier, and the units sit on the finished level. Units first saves flooring, but make sure the dishwasher can still slide out once the new floor is down. Either way, plinths and scribe fillets go on after the floor.

Can you fit quartz worktops?

Quartz is templated by the fabricator once the units are fixed, then made off site and fitted by their team. Our part is getting every carcass level and solid before the template is taken, because a stone top won't bend to hide a unit that's out. Expect a wait between templating and fitting.

Are quartz worktops safe?

In your kitchen, yes. The risk is the silica dust when engineered stone is cut, which is why the HSE said in May 2026 that dry cutting it is unacceptable. Cutting should be done wet, with extraction, at the fabricator's workshop. Lower-silica quartz is available if you'd rather choose one.

Can I have the sink in the island?

Usually, if the waste can run to a drain with enough fall. On a solid floor that can mean cutting a channel, so it's a decision to make before the new floor goes down, not after. We check the route at the survey and tell you what it involves.

Is a kitchen fitter a carpenter?

Not always. We're carpenters who fit kitchens, and that shows on the parts that don't come in a box: scribing to old walls, oak bar ends, using a dead corner for extra storage, and the stud walls and floors around the room. Here's how a carpenter differs from a joiner.

Kitchen fitting town by town

We're based in Crawley and fit kitchens across West Sussex and Surrey. Pick your town for what changes a kitchen job there.

The towns we cover around our base in CrawleyCopthorneCrawley DownEdenbridgeForest RowHassocksHenfieldHurstpierpointLindfieldMersthamSouthwaterTadworthBillingshurstBurgess HillCaterhamCranleighCuckfieldDorkingEast GrinsteadGatwickHaywards HeathHorleyHorshamLingfieldOxtedRedhillReigate10 miles15 milesCrawley base
Distances are straight-line, from our base in Crawley. Small grey dots are villages we also cover.

Thinking about a new kitchen?

Send us the plan if you have one, a few photos of the room as it is now, and your postcode. We'll get back to you, come and look at the room, and send a written, itemised quote.

Useful to send

  • The kitchen plan, or a rough sketch with sizes
  • Photos of the room, walls and floor as they are now
  • Your postcode and roughly when you'd like it done
